Guide
C-16 Islamabad: Development Progress & What Comes Next

By Bibi Masooma
Real Estate AnalystVerified author
16 min read
Short Answer:
C-16 Islamabad sits in the foothills of the Margalla Hills, along Margalla Avenue. The Capital Development Authority (CDA) approved its revised layout plan in 2023, with officials describing a sector of around 2,500 residential plots, a markaz, and Class-III shopping centres. A major development milestone came in November 2025, when CDA issued tenders worth Rs 5 billion for development works in Sub-Sectors C-16/1 and C-16/2. This represented one of the largest single infrastructure commitments among Islamabad's newer sectors. However, a mid-2026 CDA review still listed C-16 among the sectors described as "partially or fully stalled", alongside C-15 and four other 2008-era sectors.
C-16 Islamabad Development Status
C-16 Islamabad has a well-documented development history, with major milestones including the 2023 revised layout plan approval and a Rs 5 billion development commitment in 2025. However, its official 2026 status still indicates that development is not fully resolved.
For anyone researching C-16 Islamabad property or investment, the key issue is understanding how much work has actually been completed and what remains outstanding. This guide covers the sector's development timeline, CDA's major actions, and the factors that will determine its future progress.
C-16 Development at a Glance
| Milestone | Status |
|---|---|
| 2023 | Revised layout plan approved |
| 2025 | Rs 5 billion development tender |
| 2026 | Development still not fully resolved |
| Overall | Significant progress, but work remains |

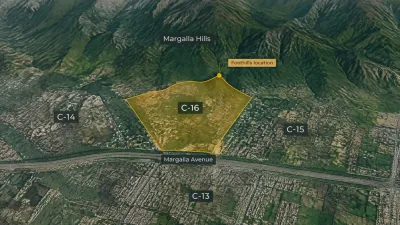

Where C-16 Fits Into Islamabad's Sector Map
C-16 is located in the foothills of the Margalla Hills, along Margalla Avenue, the same general corridor and geography that C-14 occupies. This isn't a coincidence, both sectors sit within the C-series cluster of newer Islamabad sectors that CDA has been working to bring online after decades of delay, alongside C-13 and C-15. Officials confirmed this location as far back as 2023, when Dawn reported CDA's decision to formally begin development work in the sector.

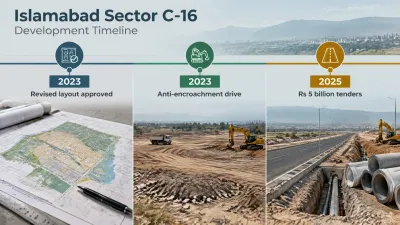

That 2023 report is worth reading closely, because it establishes several concrete facts about the sector that later announcements have built on rather than contradicted. CDA's board approved a revised layout plan for C-16, and the then CDA Chairman, Noorul Amin Mengal, stated that planning and survey issues in the sector had been settled, clearing the way for development tenders. Officials at the time also disclosed specific numbers: the sector was planned to include around 2,500 residential plots, along with a markaz and class-III shopping centres, giving C-16 a genuinely sizeable footprint compared to some of Islamabad's smaller infill sectors.
The 2023 Anti-Encroachment Drive
Alongside the layout approval, CDA's enforcement wing and Land Directorate carried out an anti-encroachment operation in C-16, specifically targeting what officials described as an "illegal Afghan settlement" and other unauthorised constructions within the sector's boundaries. This kind of enforcement action is a routine, if sometimes contentious, part of preparing a sector for formal development, since CDA generally needs a cleared site before infrastructure contractors can begin road-building and utility work. The fact that this specific step was necessary in C-16 also tells you something about the sector's on-the-ground condition at the time: land that had sat undeveloped for years had, in the interim, attracted informal settlement and construction that needed to be addressed before formal development could proceed.
Why 2023's Announcement Didn't Immediately Translate Into a Finished Sector
It's worth being honest about a pattern that shows up repeatedly in CDA's sector-development history, and C-16 is a clear example of it: a layout approval and a stated intention to invite tenders is a meaningful step, but it's not the same as development actually being completed, or even necessarily started at scale, in the following months. Several years passed between the 2023 announcement and the next major, verifiable development milestone for C-16, which suggests that whatever timeline the engineering wing had prepared back in 2023 either slipped considerably or that the intervening steps, finalising tender documents, securing budget approval, resolving any further legal issues, took considerably longer than the initial announcement implied.
This isn't unique to C-16. CDA's own officials have separately acknowledged what one source described as the authority's "poor track record" on sector development timelines, citing sectors like E-12, which was originally launched in 1989 and still wasn't fully developed decades later. Understanding this pattern is useful context for weighing any current announcement about C-16's progress: an announcement of intent is a genuine, positive signal, but it's historically been an unreliable predictor of exactly when a sector will actually reach possession.
What the Timeline Suggests
| Stage | What It Means |
|---|---|
| 2023 Layout Approval | Important planning milestone, but not completed development |
| Tender Preparation | Requires documentation, approvals and budget allocation |
| 2025 Development Tender | Stronger evidence of actual infrastructure commitment |
| 2026 Status | Development still not fully resolved |
| Key Lesson | Announcements are positive signals, but not guaranteed possession timelines |
The November 2025 Turning Point
The next major, verifiable milestone for C-16 came in November 2025, and it was substantial. CDA's official announcement, issued under the direction of Chairman Muhammad Ali Randhawa, confirmed that tenders for development works in Sub-Sectors C-16/1 and C-16/2 had been published in newspapers, with an estimated cost of Rs 5 billion for these works. To put that figure in context, it's dramatically larger than the roughly Rs 67 million CDA committed around the same time to completing road infrastructure and culverts in neighbouring C-15, a sector at a broadly similar development stage. A commitment of this scale suggests C-16's remaining infrastructure needs, roads, sewerage, water supply, and general sub-sector development across two separate sub-sectors, were considerably more extensive than what remained to be done in C-15. For broader context on how major CDA infrastructure projects are shaping Islamabad's property market, see Islamabad's Biggest CDA Projects in 2026.
C-16 vs C-15: November 2025 Development Commitments
| Sector | Development Area | Approx. CDA Commitment | What It Indicates |
|---|---|---|---|
| C-16/1 & C-16/2 | Roads, sewerage, water supply and related infrastructure | Rs 5 billion | A major infrastructure push covering two sub-sectors |
| C-15 | Roads and culverts | Rs 67 million | A much smaller infrastructure commitment at the time |
The difference in funding provides useful context when assessing the scale of work still required in C-16. While the Rs 5 billion tender represented a significant step toward physical development, it should be understood as a development commitment rather than proof that the entire sector had already been completed.
That same November 2025 announcement placed C-16 within a broader wave of CDA activity: it noted that development in Sectors C-14 and I-12 had entered their final stages, with possession expected within a few months, and that Sector I-15 was beginning its own possession handover that same week, marked by a formal ceremony at the Jinnah Convention Centre. Reading C-16's Rs 5 billion tender commitment against this backdrop suggests CDA's leadership was, at that point, treating the sector as a genuine priority within its broader push to clear the backlog of stalled Islamabad sectors, even if C-16 itself was earlier in its own specific timeline than C-14 or I-15.
What Business Recorder's Coverage Adds
Separately, Business Recorder's coverage of a CDA leadership meeting on sector development gave additional texture to how officials were tracking progress across this cluster of sectors around the same period. That reporting described road infrastructure work in C-14 as progressing rapidly, with horticulture and internal electrification underway on service roads, while in C-15, officers reported that earthwork for road infrastructure was underway with sub-base work in progress. The same meeting reportedly grouped C-16 into the same broader review of ongoing and planned infrastructure projects, consistent with the picture of an authority actively managing a multi-sector development push rather than treating any single sector, C-16 included, in isolation. Readers can also verify official development activity through the CDA's infrastructure and development updates.
This kind of coverage is useful because it shows CDA's sector-development activity as an ongoing, tracked process, with specific, named officials briefing specific, named leadership on measurable progress, rather than a one-off announcement followed by silence. That said, it also underscores that as of these reports, C-16 was still being discussed in terms of underway work rather than completed infrastructure.
What the CDA Review Showed
| Sector | Reported Progress | Development Activity |
|---|---|---|
| C-14 | Road infrastructure progressing rapidly | Horticulture and internal electrification underway on service roads |
| C-15 | Earthwork underway | Sub-base work for road infrastructure in progress |
| C-16 | Included in the broader sector review | Ongoing and planned infrastructure development being tracked |
| Overall CDA Push | Multiple sectors under active review | Development progress being monitored across different infrastructure projects |
The comparison helps put C-16's position into perspective: it was part of an active multi-sector development programme, but the available reporting still described its status in terms of ongoing and planned work rather than completed infrastructure.

Mid-2026: Still Officially "Partially or Fully Stalled"
Despite the scale of the November 2025 funding commitment, a Dawn report from mid-2026 on a subsequent CDA leadership meeting grouped C-16 with C-13, C-15, D-13, E-13, and F-13 as sectors that remained, in the authority's own words, "partially or fully stalled," with development work in this group to be taken up at a subsequent meeting. The same report specifically noted that, except for partial work in C-15 and C-16, no development activity had occurred at all in the remaining four sectors of this particular 2008-era batch, a batch these six sectors share as a group because CDA originally acquired the underlying land for all of them together, on a land-sharing basis, back in 2008.
This is a genuinely useful data point precisely because it comes after the large November 2025 funding commitment, not before it. It tells you that even a Rs 5 billion tender doesn't automatically or immediately move a sector out of CDA's own "stalled" classification, presumably because the actual construction, and any remaining legal or administrative issues tied to the sector's 2008 land-sharing origin, take considerably longer to resolve than the initial funding announcement might suggest.
Comparing C-16's Trajectory to C-14's
C-14 offers a useful, if imperfect, comparison point, since it comes from a similar broader wave of Islamabad sector development, even though its specific 2008 land-sharing origin differs slightly in the details from C-16's. The development patterns of Islamabad's newer sectors can also be seen in areas such as I-16, where infrastructure, location, and future development remain important factors in assessing the sector's outlook. Our I-16 Islamabad Area Guide provides further context on how development progress can influence the long-term property outlook of an emerging sector. C-14 moved from a similarly uncertain status through to an actual possession-handover stage, driven by a specific, sustained push from CDA's current leadership, including publicly tracked milestones like street signage installation and electricity completion. C-16's own timeline, with its much larger funding commitment but still-unresolved "stalled" classification as of mid-2026, suggests it may be earlier in a broadly similar arc, assuming CDA continues to prioritise it with the same kind of sustained attention that eventually moved C-14 through to possession.
C-16 vs C-14: Development Trajectory
| Factor | C-16 | C-14 |
|---|---|---|
| Development Stage | Ongoing / partially stalled | Further advanced |
| Major CDA Push | Rs 5 billion tender | Sustained development push |
| Possession Status | Not yet fully resolved | Reached possession stage |
| Key Takeaway | Stronger recent funding, but more work remains | Clearer evidence of development completion |
What Would Confirm C-16 Has Genuinely Turned the Corner
Given this history, a few specific, checkable developments would meaningfully confirm that C-16 has moved past its "partially stalled" status into genuine, near-completion progress. A CDA statement describing the sector's basic infrastructure as having "entered its final stages," the specific language used for C-14 and I-12 at an equivalent point in their own timelines, would be a strong signal. A follow-up announcement confirming that the Rs 5 billion tender's work has substantially progressed or completed, rather than simply having been issued, would be another. And a formal reclassification of C-16 out of the "stalled" category in a subsequent CDA leadership review would be the clearest possible confirmation. As of the most recent reporting available, none of these three markers had been publicly confirmed.
Understanding CDA's Broader Sector-Development Push
C-16's story makes considerably more sense when placed inside the broader institutional push CDA's current leadership has been running across several sectors simultaneously, rather than treated as an isolated case. Under Chairman Muhammad Ali Randhawa, CDA has periodically formed dedicated working groups, one specifically focused on accelerating development in newer sectors, and a separate one focused on rehabilitating and modernising Islamabad's older, already-developed areas. This structural approach, splitting responsibility between finishing what's unfinished and maintaining what's already built, gives some insight into why progress across sectors like C-16, C-15, C-14, E-12, and I-12 hasn't moved in lockstep: each sector's specific legal, administrative, and construction status determines how quickly it moves through CDA's internal pipeline, even when overall institutional attention and funding are genuinely increasing. For a wider understanding of how these areas compare, see our guide to Islamabad's sectors and their development status.
This broader context matters for anyone tracking C-16 specifically, because it means the sector's fate isn't purely a function of C-16's own file, it's also shaped by how CDA's leadership allocates attention and resources across its entire backlog of stalled and developing sectors at any given time. A change in CDA leadership, a shift in budget priorities, or a decision to prioritise a different sector in the same batch could all plausibly affect C-16's specific timeline, independent of anything happening within the sector's own boundaries.
CDA's Broader Sector-Development Approach
| Sector | Current Development Context | Key Factor Affecting Progress |
|---|---|---|
| C-16 | Active development with major infrastructure commitments | Construction progress, funding and administrative approvals |
| C-15 | Partial development and ongoing sector issues | Affected-person matters and infrastructure |
| C-14 | Significantly more advanced than C-15 and C-16 | Possession and remaining development work |
| E-12 | Long-delayed sector now moving toward possession | Land and administrative issues |
| I-12 | Advanced development and possession activity | Remaining infrastructure and handover |
| Other stalled sectors | Progress varies considerably | Legal, financial and administrative constraints |
Reading Between the Lines of Official Announcements
One further skill worth developing, especially for a sector like C-16 with a genuinely long documented history, is distinguishing between different types of official CDA communication and understanding what each one actually commits the authority to. A board-level layout approval, like the one C-16 received in 2023, commits CDA to a specific plan but not to a specific construction timeline. A published tender, like the Rs 5 billion commitment from November 2025, commits CDA to seeking a contractor for specific, defined work, and represents a real budget allocation, but construction can still be delayed by contractor selection processes, unexpected site conditions, or further administrative hurdles. A statement that infrastructure has "entered its final stages" represents the closest thing to a genuine, near-term completion signal in CDA's typical communication pattern, since this specific language has, in sectors like C-14, preceded an actual possession announcement within a period of months rather than years.
C-16, as of the most recent available reporting, has reached the second of these three stages, a funded, published tender, but not yet the third. Recognising exactly which stage a sector is at, rather than treating any positive-sounding announcement as equally meaningful, is one of the more useful analytical habits a careful buyer or investor can develop when following Islamabad's ongoing sector-development pipeline.
Where This Shows Up on Milkiyat
For investors trying to understand where C-16 fits within Islamabad's wider property landscape, the sector is best viewed alongside other emerging areas where development progress, infrastructure spending, accessibility, and long-term potential are still evolving. Ultimately, C-16's investment case will depend less on announcements alone and more on whether the current development commitments translate into visible, sustained progress on the ground.
Frequently Asked Questions
1. Where exactly is C-16 located?
It sits in the foothills of the Margalla Hills, along Margalla Avenue, in the same general corridor as neighbouring Sector C-14.
2. How many plots does C-16 have?
Officials disclosed in 2023 that the sector was planned to include around 2,500 residential plots, along with a markaz and class-III shopping centres.
3. How much has CDA actually committed to developing C-16?
In November 2025, CDA issued tenders worth an estimated Rs 5 billion for development works in Sub-Sectors C-16/1 and C-16/2, a substantially larger commitment than several neighbouring sectors received around the same time.
4. Is C-16 fully developed now?
No. As of a mid-2026 CDA review, the sector remained grouped among sectors classified as "partially or fully stalled," even after the large 2025 funding commitment.
5. Why did it take so long between the 2023 announcement and real progress?
CDA's own track record on sector-development timelines has historically been slow, and officials have acknowledged this pattern in other sectors as well. The gap between an announced intention and actual, completed infrastructure has often stretched to years rather than months.
6. Is C-16 further along than C-15?
Based on the scale of committed funding, Rs 5 billion versus roughly Rs 67 million, C-16's remaining infrastructure needs and the resources allocated to it appear larger, though both sectors were still grouped together as "partially or fully stalled" as of the most recent CDA review available.
7. What should I watch for to know if C-16 has genuinely progressed?
Look for a CDA statement describing basic infrastructure as having entered its "final stages," confirmation that the Rs 5 billion tendered work has substantially progressed, and a formal reclassification out of "stalled" status in a future CDA review.
