Guide
E-12 Islamabad Possession 2026: 37 Years Later, What Allottees Actually Got

By wajahat Ali
Real Estate Analyst
10 min read
Guide

By wajahat Ali
Real Estate Analyst
10 min read
Islamabad's Sector E-12 was launched in April 1989. The first possession letters worth taking seriously arrived in June 2026. That is a 37-year gap between a state authority selling plots to government employees, overseas Pakistanis, and the general public and that same authority making the land buildable. This article documents what has actually happened, what the June 2026 possession process does and does not deliver, and what buyers circling E-12 on possession news need to verify before paying a premium.
At Milkiyat, we treat E-12 as the single most important case study in Pakistani public-sector land delivery. If you want to understand why buyers flee to private societies despite their weaker approval status than CDA's own sectors, E-12 is the answer.
Two concrete developments moved E-12 from perpetual announcement to partial delivery.
First, in early June 2026, the CDA Board approved possession handover covering roughly 2,000 plots in sub-sectors E-12/2 and E-12/3, alongside about 1,000 plots in I-12/1. Reporting at the time indicated Interior Minister Mohsin Naqvi was expected to personally distribute possession letters a signal of federal-level ownership of the issue.
Second, and more operationally meaningful: on June 16, 2026, CDA's Sector Development Division-II issued a memorandum stating that plots in Sector E-12 were ready for possession following completion of development work, with lists of eligible plots forwarded to the Directors of Estate Management-I and Estate Management-II for processing. The same memorandum covered ready plots in C-14 and I-12.
A discrepancy worth flagging: announcements around the Board approval cited ~2,000 E-12 plots, while Dawn, citing engineering wing sources, reported around 1,500 plots ready across three sub-sectors of E-12. We could not reconcile these figures from public records. The practical implication for allottees is the same either way: aggregate numbers mean nothing what matters is whether your plot number is on the Estate Management eligible list.

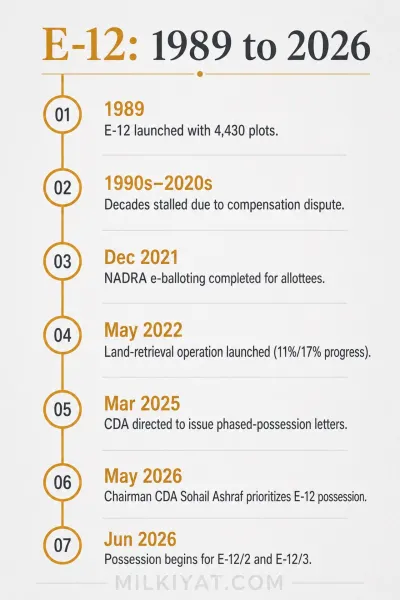

April 1989: CDA launches Sector E-12 with 4,430 plots, marketed to the general public, government employees, and overseas Pakistanis. The originally promised delivery timeline is itself disputed across records contemporaneous commitments have been variously reported as one, two, and three years. We flag this rather than pick a number; on any version, the promise was broken by the early 1990s.
1990s–2010s: The sector stalls almost entirely. The core blockage: local villagers roughly 1,200 affectee families — whose land was acquired were never compensated, and refused to vacate. Large parts of the sector sit under adverse possession. Meanwhile CDA continues launching and collecting money for other sectors. Since completing D-12 in 2008, the authority has not delivered a single fully developed new sector.
December 2021: Following an Islamabad High Court commission's direction that CDA resolve the compensation issue, the first NADRA-conducted e-balloting allots alternative plots to 162 villagers. Further ballotings follow, taking allotments to affectees to 282 plots by early 2022 though issuance of the actual allotment letters lags behind the ballotings themselves.
May 2022: CDA's enforcement wing, backed by police with magisterial cover, conducts a major land-retrieval operation and restarts development. At that point, physical progress stood at roughly 11% in E-12/2 and 17% in E-12/3 thirty-three years after launch.
March 2025: Then-chairman Muhammad Ali Randhawa directs that possession letters for E-12 be issued in phases after Eid, subject to completion of development works and payment of development charges.
May 2025: The E-12 Action Committee, led by Ateeq Sheikh, publicly demands a full waiver of development charges, arguing that an authority which failed to develop the sector for over three decades cannot reasonably bill allottees for development. An 84-year-old allottee claimed at the time that around 1,700 allottees had died waiting for possession a figure we could not independently verify, but one that captures the generational scale of the delay. Committee members also flagged hazardous overhead high-tension lines crossing the sector as an unresolved safety issue.

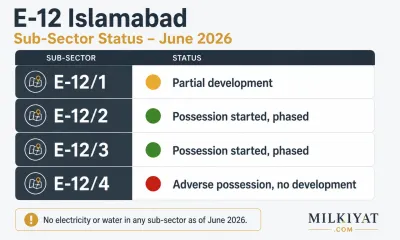

May 2026: New CDA chairman Lt (retd) Sohail Ashraf directs the engineering wing to complete E-12 on a priority basis and the land directorate to resolve legitimate compensation cases. At this point CDA holds possession of land in roughly two sub-sectors; one sub-sector E-12/4, remains fully under adverse possession with no development at all, and another is partially occupied.
E-12 is the most visible failure in a wider pattern. CDA currently holds 13 acquired residential sectors, of which eight are essentially stalled; active work is limited to a handful including C-14, I-15, and I-12. Sectors C-15, F-13, D-13, and E-13 remain trapped in the same compensation-and-balloting deadlock that froze E-12 for three decades C-15's Built-Up Property award was announced in 2016 and compensation remains unpaid a decade later.
This delivery failure is the structural reason Islamabad's housing supply migrated to private societies, with all the NOC and title risks that shift created ,the dynamic we've documented in our investigation of CDA's enforcement sweep in B-17 and our regulatory map of the societies that filled the vacuum along the airport belt. When the state authority takes 37 years to deliver a sector, the vacuum gets filled by developers selling files against land they may not fully own. E-12's belated delivery, if completed, is the single best thing CDA could do to restore the credibility of public-sector allotment which is why it deserves scrutiny, not just celebration.
Grey structure, finishing, and the real all-in number: what a 1 Kanal house actually costs to build in Islamabad–Rawalpindi in 2026 — with July steel and cement rates verified against news sources, plus a realistic tier-by-tier budget.
A mid-finish 10 marla double story house in Rawalpindi or Islamabad costs about PKR 1.6–2.3 crore in 2026. Here’s the honest, commission-free breakdown by build phase.
Ask five contractors for a price on the same 5 marla plot and you’ll get five numbers. Here’s the honest 2026 breakdown for the twin cities — grey structure at PKR 60–75 lakh, turnkey at 1.0–1.5 crore — plus the current cement, steel and brick rates driving your budget. No dealer markup.
Bahria Enclave Islamabad isn't priced as one society each of its sixteen sectors runs its own rate, from Sector O's PKR 22 lac entry-level 5 Marla plots to Sector C's PKR 7.5 crore 4 Kanal parcels.
June 2026: Board approval, the June 16 memorandum, and the start of phased possession in E-12/2 and E-12/3.
This is where dealer messaging and ground reality diverge, so let's be precise.
A possession letter permits the allottee to take physical possession of the demarcated plot and proceed toward construction building plan approval, and eventually a completion certificate. It is a milestone. For E-12 allottees, many of whom are second- or third-generation heirs of the original buyers, it is a genuinely significant one. If you're inheriting an E-12 allotment, note that the mutation of inheritance must be completed in the revenue and CDA record before you can process possession ,our guide to verifying your twin-cities plot documents covers how that chain works.
What the June 2026 possession does not include, per reporting at the time of the handover process:
Possession news reliably produces a dealer-driven price run before ground reality catches up. If you're considering buying an E-12 plot or an heir's allotment in the current market, verify in this order:
For buyers comparing E-12 against alternatives at similar price points, our analysis of whether a plot or a built house delivers better ROI in 2026 and our breakdown of which authority actually has jurisdiction where are the right starting points. And if your interest in E-12 is rental-yield driven once construction becomes viable, calibrate expectations against verified Islamabad rental-yield data (covered in the ROI analysis linked above) rather than dealer projections.
Every June 2026 headline framed the possession handover as relief. It is. But relief is not restitution. Allottees paid CDA in 1989 rupees; they received buildable land — partially, conditionally — in 2026. No official announcement has addressed compensation for 37 years of lost use, no mechanism exists for the estates of allottees who died waiting, and the authority is billing the survivors development charges on top. The villagers whose land was taken waited three decades for the compensation that was the legal precondition of the entire scheme.
The E-12 file should not close with possession letters. It should close with a public accounting of where the 1989 payments went, why eight sectors remain in the same trap, and what binding timeline governs E-12/4, C-15, E-13, F-13, and D-13. Until then, every new CDA sector announcement should be read with E-12's timeline taped next to it.
Milkiyat.com is a commission-free research platform. We do not sell plots, or earn from transactions in any sector or society we cover. All claims above are sourced from public reporting by Dawn, The News, ProPakistani, and CDA's own published statements; contested claims are flagged as such.
Yes, partially. The CDA Board approved handover for E-12/2 and E-12/3 in June 2026, and a June 16, 2026 memorandum initiated processing of eligible plots through Estate Management. Possession is phased and conditional on development charges. E-12/4 remains undeveloped.
Figures conflict: ~2,000 (Board approval announcements) versus ~1,500 ready plots (Dawn, citing engineering sources). Verify your specific plot number rather than relying on totals.
Not as of June 2026. Possession enables construction formalities; utilities remain a separate unresolved track.
Primarily an unresolved land compensation dispute with local affectees, broken only after IHC intervention, NADRA e-ballotings from December 2021, and a 2022 land-retrieval operation.
It carries genuine CDA title a real advantage but expect possession-news premiums, verify sub-sector and eligible-list status, price in development charges, and assume no near-term utilities.
