Guide
Rawalpindi Ring Road Phase 2: Route, Affected Housing Societies & Investment Impact 2026

By wajahat Ali
Real Estate Analyst
11 min read
Rawalpindi Ring Road Phase 1 is almost open. After years of delays, revised budgets, and one political controversy that put the entire project on hold in 2021, the 38.3 kilometre corridor from Baanth on GT Road to Thalian Interchange is now functional, though the Thalian Interchange itself opened later as a separate project.
The conversation has now shifted to Phase 2: the proposed extension from Thalian toward Sangjani and eventually toward Zero Point Islamabad. For real estate investors in Rawalpindi and Islamabad, this matters because Phase 2 would complete the ring, integrate the corridor with CPEC, and open an entirely new belt of developable land between the airport and northern Islamabad.
This guide covers everything verified as of June 2026: Phase 1 current status, Phase 2 proposed route and timeline, which housing societies stand to benefit, and the honest investment risk picture.
Rawalpindi Ring Road: The Full Picture Before Phase 2
To understand Phase 2, you need to know exactly what Phase 1 built and what it left unfinished.
Phase 1 at a Glance (June 2026)
| Detail | Specification |
|---|---|
| Total Length | 38.3 kilometres |
| Start Point | Baanth, GT Road (N-5) |
| End Point | Thalian, M-2 Motorway |
| Road Type | 6-lane controlled-access expressway |
| Design Speed | 120 km/h |
| Contractor | Frontier Works Organisation (FWO) |
| Design Consultants | NESPAK + BOTEK (Turkey) |
| Revised Cost | Rs. 50–53 billion (originally Rs. 33 billion) |
| Land Acquired | 8,992 Kanals at Rs. 6.7 billion |
| Completion Status | ~90% complete; road open; Thalian Interchange separate |
| Supervising Authority | Rawalpindi Development Authority (RDA) |
The five interchanges on Phase 1 are: Baanth, Chak Beli Khan, Adiala Road, Chakri Road, and Thalian. The Thalian Interchange was separated into its own project with a Rs. 4.8 billion PC-1. The main corridor opened to traffic with a temporary motorway connection while the full interchange is completed.

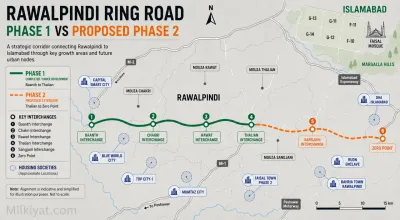

What Is Rawalpindi Ring Road Phase 2?
Phase 2 is the proposed extension of the Ring Road from Thalian toward Sangjani, and from Sangjani eventually to Zero Point Islamabad, completing a full orbital ring around the twin cities.
As of June 2026, Phase 2 is not under construction. It exists as:
- A commissioned feasibility study (AECOM and others referenced in planning discussions)
- An approved 3.8 km segment from DHA Phase 3 to AWT Plaza Sangjani (CDA 1.4 km + NHA 2.4 km, approved August 2025)
- A planned 13.5 km stretch from Thalian to Hakla, under active planning
- A long-range conceptual alignment toward Zero Point Islamabad

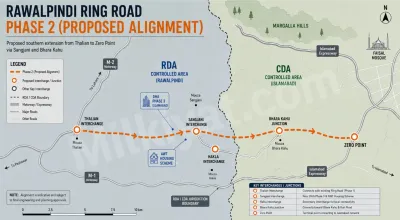

Phase 2 Route: Confirmed vs. Proposed
| Segment | Length | Status | Authority |
|---|---|---|---|
| DHA Phase 3 → Sangjani (AWT Plaza) | 3.8 km | Approved (August 2025) | CDA 1.4 km + NHA 2.4 km |
| Thalian Interchange (standalone) | — | PC-1 approved Rs. 4.8B | RDA / Punjab |
| Thalian → Hakla | ~13.5 km | Planning stage | Under study |
| Sangjani → Bhara Kahu → Zero Point | TBD | Conceptual only | Not approved |
| CPEC Integration Link | TBD | Feasibility commissioned | NHA / Federal |
Two options are on the table for the full Phase 2 alignment. The first is a standalone new road extension following the Thalian–Hakla–Sangjani corridor. The second is a motorway-merger option widening existing motorway lanes rather than building an entirely new extension. If the motorway-merger approach is adopted, the full Phase 2 road may never be built.
Phase 2 and CPEC: Why This Matters for Investors
One of the key stated objectives of Phase 2 is to link the Rawalpindi Ring Road directly with the China-Pakistan Economic Corridor (CPEC) network. A completed ring with CPEC integration would allow heavy vehicles to travel between GT Road, the motorway network, the airport, and CPEC routes without entering city traffic.
For real estate, CPEC-linked corridors historically attract industrial zone development and Special Economic Zone (SEZ) planning. Land near Phase 2's proposed Hakla and Sangjani alignment has already drawn early attention from commercial investors on this basis.
The risk: CPEC-linked projects in Pakistan have frequently faced delays tied to financing and coordination between federal and provincial authorities. Phase 2's CPEC objective is real, but its timeline is not.

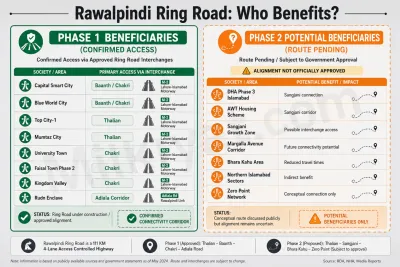

Housing Societies Affected by Rawalpindi Ring Road Phase 2
Phase 1 Confirmed Beneficiaries
| Society | Nearest Interchange | Access Type | Investment Verdict |
|---|---|---|---|
| Faisal Town Phase 2 | Thalian + Chakri | Direct — two interchanges within society | Strongest confirmed beneficiary |
| Capital Smart City | Thalian + Smart City Interchange | Direct — motorway-facing position | High benefit, partly priced in |
| Blue World City | Chakri Road | Near Chakri Interchange | Access benefit clear; verify legal status first |
| RUDN Enclave | Adiala Road | Direct — sits at Adiala Road / Ring Road intersection | Strong corridor position |
| Top City-1 | Thalian | Near Thalian Interchange | Benefits from airport corridor proximity |
| DHA Phase 3 | Sangjani / Phase 2 start | Anchors the Phase 1–Phase 2 junction | High strategic value, stable DHA credentials |
Phase 2 Potential Beneficiaries (Route Not Finalised)
| Area / Society | Phase 2 Connection | Risk Level |
|---|---|---|
| AWT Housing Scheme (Sangjani) | Near confirmed 3.8 km CDA/NHA segment | Low — segment approved |
| Societies near Hakla | On 13.5 km Thalian–Hakla planning stretch | Medium — planning stage only |
| Land near Bhara Kahu | CDA conceptual plan only | High — no approval yet |
| Societies marketing "near Zero Point Ring Road" | Conceptual alignment only | Very High — no route confirmed |
Buyer warning: Multiple developers are already marketing plots using "Rawalpindi Ring Road Phase 2" as a selling point. Until RDA confirms a final route and land acquisition begins, any Phase 2 location premium is speculative. Verify directly with RDA before purchasing.
Property Price Impact: Phase 1 vs. Phase 2 Corridor
Phase 1 Corridor: Price Movement Already Recorded
- Faisal Town Phase 2: 5 Marla plots appreciated 35–50% from 2023 base prices as Ring Road progress accelerated
- Capital Smart City: Premium blocks near Thalian saw 20–35% price movement — partly Ring Road, partly own development milestones
- RUDN Enclave: Adiala Road positioning drove strong secondary market activity; 1 Kanal prices firmed significantly through 2024–2025
- Blue World City: Appreciation recorded but buyers should weigh against regulatory clarity requirements
The market typically prices in anticipated road benefits 12–24 months before the road opens. Some appreciation on Phase 1 societies has already occurred.
Phase 2 Corridor: Early Price Discovery
Land near the proposed Thalian–Sangjani–Hakla alignment is still in early price discovery:
- Raw agricultural land (Mouza level) in the Sangjani and Hakla belt is being quietly acquired by land aggregators
- No organised society launches have targeted Phase 2's exact corridor yet because the route is not finalised
- When route confirmation and land acquisition begin, prices in directly affected Mouzas typically move 15–30% within 12–18 months
Phase 2 is a long-horizon play. A conservative estimate puts construction beginning no earlier than 2027–2028.
Thalian Interchange: The Bridge Between Phase 1 and Phase 2
The Thalian Interchange is simultaneously:
- The western terminus of Phase 1, connecting the Ring Road to M-2 Motorway
- The starting point of Phase 2, from which the Thalian–Hakla extension will branch
- The airport corridor gateway, providing road access toward Islamabad International Airport
A separate Rs. 4.8 billion PC-1 was approved for it. When completed, the interchange will significantly strengthen the value case for Thalian-adjacent societies — Faisal Town Phase 2 and Capital Smart City in particular.
Until it is complete, these societies benefit from a temporary motorway connection , functional, but not the full connectivity picture yet.
Industrial Zone and SEZ Planning Along the Ring Road
Punjab's original plan included an industrial zone along the corridor, with ongoing discussions about Special Economic Zones (SEZs) near key interchange points.
If industrial and SEZ development materialises along Phase 2's corridor, the impact would extend beyond residential plots into commercial and warehouse-type development. The Sangjani and Hakla areas would be primary beneficiaries.
Current status: Industrial zone planning is confirmed as an objective by official Punjab statements but no specific zone has been gazetted or tendered as of June 2026. Treat this as a future catalyst, not a current reality.

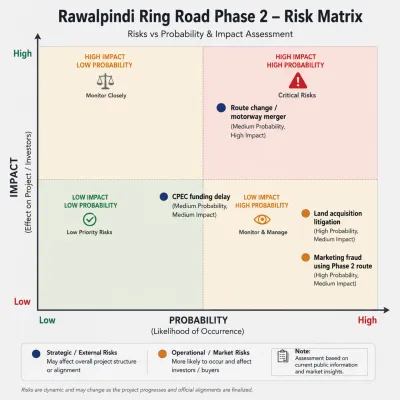

Key Risks and What Buyers Must Watch For
1. Route Is Not Final
The motorway-merger alternative is a live option. If chosen, the full Phase 2 extension may not be built.
2. Land Acquisition Delays Are Structurally Common
Phase 1 took nearly 15 years from first proposal (1991) to foundation stone (2022). Phase 2 will face similar disputes in a higher land value environment.
3. Marketing Fraud Risk
RDA has already issued public warnings against societies marketed using unverified Ring Road adjacency claims. Always verify NOC and LOP status on the RDA portal before paying any token money.
4. Budget Escalation Pattern
Phase 1 started at Rs. 23.6 billion and ended at Rs. 50–53 billion, more than double. Phase 2 estimates should be treated as underestimates until a final PC-1 is approved.
5. Timeline Uncertainty
Phase 1 missed its December 2025 deadline repeatedly. Phase 2 has no official start date. Do not factor Phase 2 into any investment requiring a return within the next 3–4 years.
Milkiyat.com Investor Verdict
The Rawalpindi Ring Road is a genuinely transformative project. Phase 1 alone has proven that by unlocking the western corridor for residential development at scale. The appreciation in Faisal Town Phase 2, Capital Smart City, and RUDN Enclave reflects genuine infrastructure-driven demand.
Phase 2 is a different story. It is a legitimate strategic objective with real preliminary work happening, but it is not a near-term certainty.
Investors looking at Phase 2 corridor land should:
- Focus only on societies with existing RDA NOC or LOP approval that happen to be near the proposed corridor
- Treat any Phase 2 location premium as a 5–7 year horizon play
- Verify every society's legal status on the RDA portal before committing funds
- Ignore marketing materials quoting a specific Phase 2 opening date — no such date exists
For verified listings near the Phase 1 and Phase 2 corridors, browse Milkiyat.com's twin cities property database with direct NOC verification links on every project page.
Frequently Asked Questions
What is Rawalpindi Ring Road Phase 2? Rawalpindi Ring Road Phase 2 is the proposed extension from Thalian Interchange toward Sangjani and eventually Zero Point Islamabad. It aims to complete the ring around the twin cities and integrate with CPEC. A feasibility study has been commissioned but construction has not started as of June 2026.
When will Rawalpindi Ring Road Phase 2 be completed? No official completion date has been announced. The Thalian Interchange — the only Phase 2 component under active construction, has a confirmed budget but no announced completion date. The broader extension depends on feasibility approval, land acquisition, and financing.
Which housing societies benefit from Rawalpindi Ring Road Phase 2? AWT Housing Scheme near Sangjani is the most directly positioned near confirmed Phase 2 work. Societies along the Hakla corridor may benefit once the 13.5 km Thalian–Hakla stretch is built. Any society claiming broader Phase 2 benefits should be verified with RDA before purchase.
Will Ring Road Phase 2 connect to CPEC? Yes, CPEC integration is a stated Phase 2 objective. It would allow freight movement without entering urban traffic. This depends on Phase 2 being built, which is not yet confirmed.
What is the current status of Rawalpindi Ring Road Phase 1 in 2026? Phase 1 has reached approximately 90% completion. Asphalt is laid on nearly the full 38.3 km corridor and the road is open to traffic. The Thalian Interchange is being built separately under a Rs. 4.8 billion PC-1.
How does Ring Road Phase 2 affect property prices? Land in the proposed Phase 2 corridor is in early price discovery. Prices in directly affected Mouzas typically rise 15–30% within 12–18 months of route confirmation and land acquisition announcement. Phase 2 has not yet reached that trigger point.
