Guide
Margalla Enclave Utility Connection Process: Documents, Applications & Cost Checks

Real Estate Analyst
9 min read
A practical guide to electricity, gas and water connections, required documents, fees and utility availability in Margalla Enclave Islamabad.
Overview
A plot in Margalla Enclave is allotted, but electricity, gas and water reach it through separate steps with separate providers. The project's environmental assessment promises a full utility package, including water supply, sewerage, electrification and a gas network. What is promised for the scheme and what you can apply for on your plot today are different questions, and the answer varies by street.
This guide covers the connection process, the documents involved, the current rules on gas and the water numbers behind the plan. For the project's location, approvals and legal status, read the Margalla Enclave Islamabad guide , which this article expands on.
If you are weighing plots by readiness, Margalla Enclave listingson Milkiyat show properties advertised in the area; verify each plot’s possession and utility status with DHA.
1. What the project plans to provide

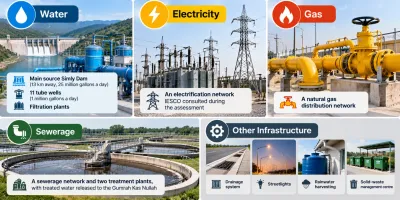

The environmental assessment lists these utilities for the scheme:
| Utility | What the assessment says |
|---|---|
| Water | Main source Simly Dam (13 km away, 25 million gallons a day), plus 11 tube wells (1 million gallons a day); filtration plants |
| Interim water | Groundwater during the first development phase |
| Long-term water | Islamabad's allocated share of Indus River water as habitation grows |
| Sewerage | A sewerage network and two treatment plants, with treated water released to the Gumrah Kas Nullah |
| Electricity | An electrification network, with IESCO consulted during the assessment |
| Gas | A natural gas distribution network |
| Other | Drainage, streetlights, rainwater harvesting, solid waste centre |
These are design commitments. The same document says development will finish in three years in one chapter and four years in the summary, and full habitation will take 20 to 25 years. Treat any completion date as unconfirmed until DHA publishes a schedule for your street.
2. The water numbers
Water is the utility the assessment itself calls a primary concern. It estimates a maximum daily demand of 8,776,213 gallons at full build-out.
Milkiyat.com finding: the interim tube wells cover about one-ninth of the full demand.
- Full demand: 8.78 million gallons a day
- Tube wells: 1 million gallons a day
- 1 ÷ 8.776 = 11.4% of the full-build demand
- Full demand against Simly Dam's stated 25 million gallons: 8.776 ÷ 25 = 35%
So the early phases of Margalla Enclave can run on groundwater, but the full scheme depends on surface water that is not yet in place. Water for early residents is therefore a supply question, not just a connection question. Our guide to development and possession status tracks which sectors are ready.
3. Electricity: how to apply

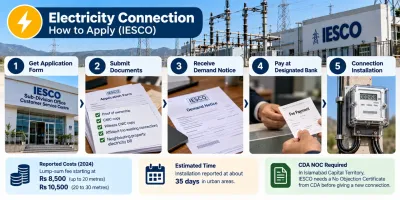

Electricity comes from IESCO. In the Islamabad Capital Territory, IESCO needs a No Objection Certificate from CDA before it can give a new connection, according to the federal power minister's statement to the National Assembly. For a single-phase domestic meter, reports of IESCO's process list these steps:
- Collect the application form from an IESCO sub-division office or customer service centre. Reports mention five copies of an application and agreement form.
- Submit documents. The usual list is proof of ownership, a copy of your national identity card, a copy of a witness's identity card, an affidavit that no connection exists at the premises, and a neighbouring property's electricity bill.
- Wait for the demand notice after IESCO verifies the file.
- Pay the demand notice at the designated bank.
- Receive the connection after IESCO verifies the payment. Reports put installation at about 35 days in urban areas.
Costs reported in 2024: a lump-sum fee starting at Rs8,500 for a service line up to 20 metres, and Rs10,500 for 20 to 30 metres. Check IESCO's current schedule.
Two questions specific to your plot:
- What counts as proof of ownership? The IESCO list names a registry. A plot on instalments may not have one. Ask DHA and IESCO what they accept at the allotment stage, and ask whether a temporary construction connection is available.
- Is there a neighbouring bill to attach? In a street where no one has built yet, there may be none. Ask IESCO what it will accept instead.
4. Gas: what has changed

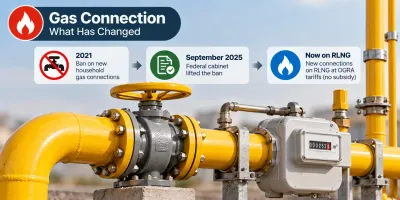

The gas position is different from a few years ago. A ban on new household connections ran from 2021. The federal cabinet lifted it in September 2025, but all new connections are now on re-gasified liquefied natural gas (RLNG) at tariffs set by OGRA, without subsidy. Local gas is not available for new applicants.
What this means in practice:
- RLNG costs more than local gas. The petroleum minister said it is still 30 to 35% cheaper than LPG.
- Costs reported: a security deposit of Rs20,000, and an urgent processing fee of Rs25,000 for faster handling. Confirm both with SNGPL.
- The network must exist. Where there is no pipeline, an applicant has to ask for an extension. SNGPL's site visit assesses technical feasibility.
- Societies need an RLNG network. SNGPL's earlier notification covered housing schemes already supplied with RLNG.
Whether a gas network has been laid in your part of Margalla Enclave is for DHA and SNGPL to confirm. Until a connection is confirmed in writing, plan for alternative cooking and heating.
5. Water and sewerage
Water and sewerage in a DHA scheme are generally supplied by the developer's own network, not by a public utility you apply to directly. That means the application goes through DHA. Ask DHA:
- Is a water main laid on your street?
- What is the connection charge, and who pays for the service line?
- What is the monthly billing basis?
- Is the sewer line connected to a working treatment plant?
Do not assume a service exists because a pole, pipe or manhole is visible. Our guide to checking whether utilities are actually available at a plot explains how to verify each service on site. This guide covers the application process that follows.
Before submitting any application, confirm that the plot number, street, sector and applicant name match across the allotment or transfer documents and the provider's form. If ownership is joint, ask whether all owners must sign or provide identification. Keep scanned copies of every document and record the date, office and reference number for each submission. Do not hand over original documents unless the provider specifically requires them and gives a receipt.
A connection application can also be delayed if the street is not ready, the service line is too far from the main, the building plan is not approved, or the provider has not received the required NOC. Ask which issue applies to your plot instead of relying on a general estimate for the whole scheme.
6. A checklist of documents to prepare
| Document | Electricity | Gas | Water and sewerage |
|---|---|---|---|
| National identity card copy | Yes | Yes | Yes |
| Allotment, possession or ownership proof | Yes | Yes | Yes |
| Witness identity card copy | Reported | Check | Check |
| Affidavit of no existing connection | Reported | Check | Check |
| Neighbouring bill | Reported | Check | No |
| CDA or DHA NOC | Yes (in ICT) | Check | DHA |
| Approved building plan | Check | Check | Check |
"Reported" means it appears in published accounts of the process. "Check" means confirm with the provider.
7. Cost checks before you commit
- Ask for a written estimate from each provider before building.
- Ask who pays for service lines. The distance from the main to your boundary changes the fee.
- Ask about security deposits and whether they are refundable.
- Budget for delays. Installation times depend on the provider and your street.
- Keep every receipt and demand notice. They are your proof if a connection is disputed.
Our price tracker shows plot prices. Utility connection costs come on top.
8. Where to look next
If utilities matter more to you than the entry price, compare Islamabad property listings, where established societies already have connections. If you want a house with services in place, browse houses for sale in Islamabad.
If you have chosen Margalla Enclave, browse all properties in Margalla Enclave on Milkiyat, listed by KYC-verified agents.
Frequently asked questions
Does Margalla Enclave have electricity?
The project plans an electrification network, and electricity connections come from IESCO. Whether your street is connected is for DHA and IESCO to confirm.
Can I get a gas connection in Margalla Enclave?
New household connections are available only on RLNG since September 2025. They also need a gas network on your street, which DHA and SNGPL must confirm.
Where does Margalla Enclave get its water?
The plan names Simly Dam as the main source, with 11 tube wells and groundwater in the early phase. Indus River water is the long-term plan.
How long does an IESCO connection take?
Reports put a single-phase connection at about 35 days in urban areas after the demand notice is paid.
Do I need an NOC for electricity?
In the Islamabad Capital Territory, IESCO needs a CDA NOC before a new connection, according to the power minister's statement.
Related Margalla Enclave guides
- Margalla Enclave Plot Demarcation and Site Survey: What Buyers Should Verify
- Margalla Enclave Plot Topography: Slope, Retaining Walls and Drainage Checks
- Margalla Enclave Development and Possession Status
- Building a House in Margalla Enclave: Bylaws, Map Approval and Construction Cost
*Disclaimer: Milkiyat.com provides property-related information for general informational and research purposes only. Prices, availability, development status, approvals, charges, and other market information may change over time. Readers should independently verify ownership, documentation, approvals, NOCs, possession status, outstanding dues, and charges with DHA Islamabad, CDA, and qualified professionals before making any property or investment decision.
